Free PRINCE2 Project Management Practitioner (Version 7) PRINCE2-Practitioner Exam Questions

Last updated: · 11 practice questions with answers and explanations

Page: 1 / 20 Total 293 questions

Want more questions? Get Premium Access.

Question 1

New Single answer

Topic: Apply the PRINCE2 principles in context

Skill tested: Apply continued business justification when project evidence and forecasts change.

A regional health network is replacing a patient scheduling system. The approved business case depends on reducing missed appointments, but a pilot shows that most savings will come from a later workflow redesign that is not yet funded. The project remains within its approved time and cost tolerances, and the current delivery team can complete the software release as planned. The executive asks the project manager to continue because stopping now would make the organization appear indecisive. What is the MOST appropriate response?

Correct Answer: C. Ask the Project Board to review whether the project remains desirable, viable and achievable using the updated evidence, and decide whether to continue, change or stop.
Explanation:

Continued business justification requires the project's justification to remain valid throughout its life, not merely at approval or within delivery tolerances. The pilot changes the evidence underpinning expected benefits, so the Project Board should consider the updated business case and make the governance decision. Remaining within time and cost tolerances does not prove that the investment is still desirable, viable and achievable. Waiting until closure delays a necessary decision, while adding unfunded scope bypasses appropriate authorization and may make the project less achievable.

Question 2

New Multiple answers

Topic: Apply the PRINCE2 principles in context

Skill tested: Use management by exception and escalation when forecast stage tolerances will be exceeded.

A data-migration stage is forecast to exceed its agreed cost tolerance by 8 percent because a legacy data source is more complex than expected. The stage end date remains within tolerance, and the delivery team has identified a recovery approach that could reduce the overrun, but its success is uncertain. The project manager is considering using contingency from a later stage without informing the Project Board. Select TWO actions that best apply PRINCE2 principles. (Select TWO answers.)

Correct Answer: C. Prepare an issue report and seek Project Board direction because the stage is forecast to exceed its cost tolerance.; D. Assess the recovery approach and present its effects and options as part of the escalation, without treating an unapproved change as authorized.
Explanation:

Management by exception requires the project manager to forecast tolerance breaches and escalate them rather than wait for an actual breach. An issue report gives the Project Board the information needed to decide how to proceed. The project manager should assess credible recovery options and explain their implications, but cannot silently transfer contingency or change an approved baseline outside delegated authority. The team manager may provide specialist advice but does not approve changes to the stage tolerance. A project-level budget position does not remove the need to manage stage tolerances.

Question 3

New Single answer

Topic: Apply and tailor relevant aspects of PRINCE2 themes in context

Skill tested: Maintain a justified business case using measurable benefits and dis-benefits.

A utility company is piloting remote meter reading. The expected reduction in manual visits is a benefit, while temporary customer disruption during installation is a dis-benefit. The project manager has included both in the business case but proposes to record only the installation output and close the project once the meters are accepted. Operations will own the service after handover, and the principal savings are expected over the following two years. What is the BEST way to make the business case and benefits management approach fit for purpose?

Correct Answer: A. Specify how and when the benefit and dis-benefit will be measured, who owns each measurement, and how post-project reviews will be arranged.
Explanation:

Meters are an output; reduced visits and customer disruption are respectively an outcome-related benefit and a dis-benefit that should be considered in justification. A benefits management approach should define measurement, timing, responsibilities and post-project review arrangements. This is particularly important because the savings arise after the project and operations will own the service. Informal transfer leaves accountability unclear, omitting the dis-benefit weakens the business case, and assigning indefinite responsibility to the project manager is inappropriate once the project has closed.

Question 4

New Multiple answers

Topic: Apply and tailor relevant aspects of PRINCE2 themes in context

Skill tested: Assign business case development and benefit ownership to appropriate PRINCE2 roles.

A university's student-services project will deliver a new case-management platform. The proposed benefits include faster resolution of student enquiries and improved audit evidence. The service director will be accountable for the operational changes needed to realize those benefits, while a finance analyst can provide baseline and forecast data. The executive is willing to champion the investment but has limited time to manage benefit measures. Which TWO role arrangements are most appropriate? (Select TWO answers.)

Correct Answer: C. The Executive remains accountable for ensuring that the project has a business case and continues to represent value for money.; D. The service director acts as Senior User and is assigned responsibility for specifying and ensuring the realization of the operational benefits.
Explanation:

The Executive is accountable for the business case and for ensuring the project remains justified. The Senior User represents those who will use the outputs or have their interests affected and is responsible for specifying desired outcomes and ensuring expected benefits are realized; the service director is therefore the natural choice. The analyst can supply useful financial evidence without becoming Senior User. The Project Manager manages delivery rather than owning operational benefits indefinitely, and the supplier does not own the customer's business case.

Question 5

New Single answer

Topic: Apply and tailor relevant aspects of PRINCE2 themes in context

Skill tested: Tailor project communication arrangements to stakeholder needs and controlled information flows.

A public-sector procurement project has a distributed team, a supplier, internal auditors and community representatives. Some commercial information is restricted, while milestone information must be accessible to all stakeholders. The project currently relies on ad hoc email updates, causing inconsistent versions and missed decisions. The Project Board wants a proportionate communication management approach without creating a large reporting bureaucracy. What should the project manager recommend?

Correct Answer: B. Define stakeholder information needs, timing, formats, responsibilities, routes for communication, and appropriate access controls in the communication management approach.
Explanation:

A communication management approach should establish how and when relevant information will be communicated, to whom, by whom and through which methods. Tailoring it to stakeholder needs supports timely decisions while controlled access protects restricted procurement information. Distributing every document indiscriminately creates confidentiality and information-management risks. Board-only communication excludes stakeholders who need information, and a single weekly email cannot reliably meet different needs for decisions, controlled documents and milestone updates.

Question 6

New Single answer

Topic: Apply and tailor relevant aspects of PRINCE2 themes in context

Skill tested: Structure project governance with clear Executive, Senior User, Senior Supplier and project assurance responsibilities.

A consortium is establishing governance for a regulatory reporting project. The Chief Financial Officer is funding the work and will chair the Project Board. Business operations will use the reporting service, a technology partner will supply the platform, and independent compliance specialists must check that the project remains aligned with regulatory requirements. The CFO proposes to perform all assurance personally to keep the team small. Which arrangement is MOST appropriate?

Correct Answer: C. The CFO acts as Executive, the operations representative as Senior User, the supplier representative as Senior Supplier, and suitably independent assurance checks the project on behalf of the Board.
Explanation:

The Board should represent business, user and supplier interests through the Executive, Senior User and Senior Supplier roles. Project assurance provides the Board with confidence that the project is being conducted appropriately and should be sufficiently independent of day-to-day project management. The CFO can be Executive, but combining that role with all assurance may undermine independence and overlook specialist compliance review. The Project Manager manages the project and should not provide independent assurance; the supplier also cannot represent the business interest as Executive.

Question 7

New Single answer

Topic: Apply (and tailor) relevant aspects of PRINCE2 processes in context

Skill tested: Select appropriate Starting up a Project actions before committing to initiation expenditure.

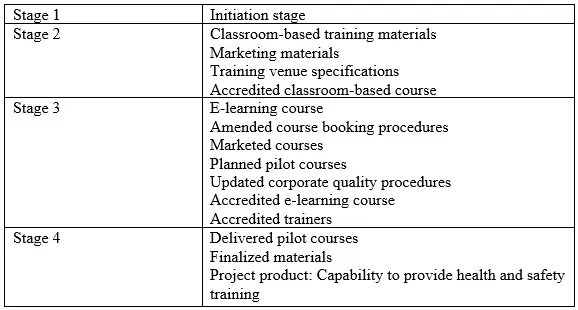

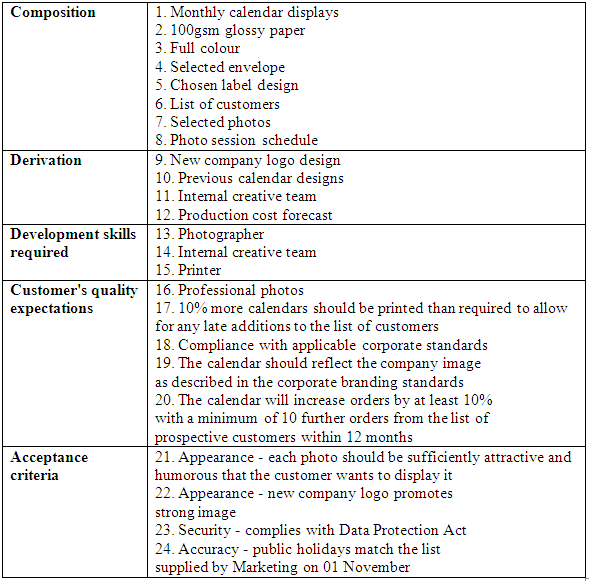

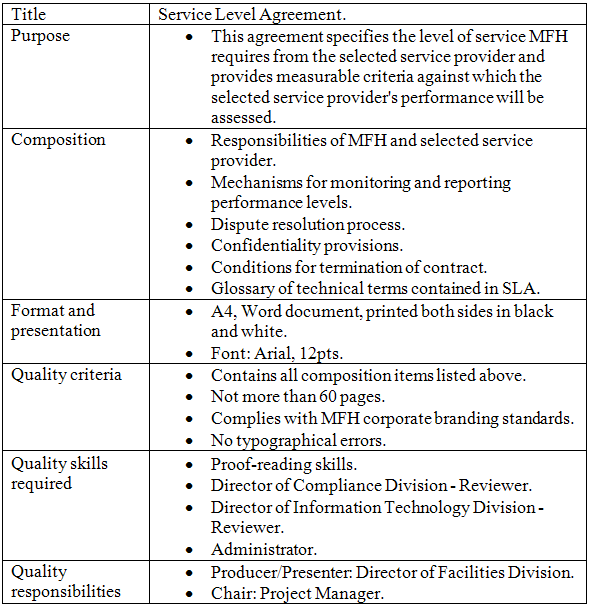

A retail group has approved a proposal to investigate a new inventory service. The sponsor wants the project manager to begin full requirements workshops immediately, although the project mandate is brief, the proposed product scope is unclear, and no delivery approach or project management team has been agreed. The group wants to limit early expenditure and avoid starting a project that cannot be justified. What is the MOST appropriate next step?

Correct Answer: C. Carry out Starting up a Project proportionately: appoint the Executive and Project Manager, capture lessons, outline the project and approach, and prepare the initiation-stage request for the Project Board.
Explanation:

Starting up a Project is a pre-project process that establishes whether there is a worthwhile and viable project to initiate. Its proportionate work includes appointing key roles, capturing relevant lessons, outlining the project and approach, and preparing the initiation stage plan and request for authorization. Detailed requirements and full planning belong later in initiation, after governance and authorization are established. Beginning delivery from a proposal bypasses controls, while developing major project information without accountable roles is inefficient and poorly governed.

Question 8

New Multiple answers

Topic: Apply (and tailor) relevant aspects of PRINCE2 processes in context

Skill tested: Prepare Starting up a Project information and role appointments for an informed initiation decision.

A logistics firm has received a mandate to explore replacing a warehouse control system. The mandate identifies the operational problem but leaves options, supplier involvement and delivery timescale uncertain. The Board wants an initiation-stage proposal that is sufficiently informed but does not fund premature detailed design. Which TWO actions belong in an appropriately tailored Starting up a Project effort? (Select TWO answers.)

Correct Answer: A. Appoint the Executive and Project Manager, and ensure the proposed project management team structure can be completed for initiation.; B. Prepare an outline business case and project product description, using the mandate and available information to frame the project.
Explanation:

Starting up a Project should establish the key management roles and develop enough outline information to support a decision about whether to initiate. An outline business case and project product description help frame the justification and intended project outcome without pretending that detailed design is complete. Detailed product descriptions and delivery-stage authorization are later work. Committing to a supplier or solution before assessing approaches risks constraining the project without adequate evidence.

Question 9

New Single answer

Topic: Apply (and tailor) relevant aspects of PRINCE2 processes in context

Skill tested: Distinguish Project Board authorization decisions from project manager day-to-day controls.

During initiation of a laboratory modernization project, the Project Manager has completed the Project Initiation Documentation and the plan for the first delivery stage. The Senior Supplier confirms that specialist capacity is available, and the Senior User accepts the proposed product descriptions. A team manager asks the Project Manager to issue work packages immediately because procurement lead times are long. The Project Board has not yet reviewed the initiation baseline. What should happen next?

Correct Answer: A. The Project Manager should submit the initiation documentation and stage plan to the Project Board so it can authorize the project and the next stage before delivery is directed.
Explanation:

Directing a Project gives the Project Board control over key decisions, including authorizing initiation, the project and subsequent stages. The completed initiation documentation and stage plan provide the basis for that decision. Acceptance of product descriptions by users and suppliers is useful input but does not replace Board authorization. Issuing work packages or beginning procurement before the relevant authority risks committing resources to an unapproved project baseline; urgency does not remove governance controls.

Question 10

New Single answer

Topic: Apply (and tailor) relevant aspects of PRINCE2 processes in context

Skill tested: Apply Directing a Project controls for exception decisions and continued authorization.

A customer-data platform project is midway through a stage when a new privacy regulation changes the required retention rules. The Project Manager forecasts that the stage plan cannot meet its original scope and date tolerances, but a revised approach may still deliver the project's intended outcomes at higher cost. The Project Board has not delegated authority to accept an exception plan. What is the MOST appropriate action?

Correct Answer: C. The Project Manager should raise an exception report with options and impacts; the Project Board should decide whether to request an exception plan and authorize the response.
Explanation:

A forecast breach of stage tolerances must be escalated through an exception report. The report should give the Project Board the forecast, impacts and available options; the Board can then request an exception plan and decide whether to authorize a revised approach. The project manager cannot unilaterally change the approved stage baseline simply because the change is regulatory. The supplier may advise on feasibility but cannot make the governance decision, and delaying reporting undermines timely control.

Question 11

New Multiple answers

Topic: Apply (and tailor) relevant aspects of PRINCE2 processes in context

Skill tested: Use Directing a Project decisions to authorize initiation and maintain business justification.

A city transport authority has received a project mandate for an accessible ticketing upgrade. The proposed Executive has asked the Project Manager to prepare an initiation-stage plan, but the mandate contains no approval to spend beyond a small feasibility budget. Early analysis finds two delivery approaches with materially different costs and user impacts. The Board wants to retain control without making technical decisions that belong to the team. Which TWO actions are appropriate under Directing a Project? (Select TWO answers.)

Correct Answer: A. The Project Board considers the request to initiate and authorizes the initiation stage, with appropriate direction on any limits or conditions.; B. The Project Board keeps the business case under review and uses the emerging evidence to decide whether continued investment remains justified.
Explanation:

The Project Board authorizes the initiation stage and can set conditions on its work. Through Directing a Project, it also maintains overall control and ensures the project remains justified as evidence develops. This allows the team to investigate alternatives while preserving governance. Choosing detailed specifications and allocating team tasks would draw the Board into management detail. A mandate is not automatic authority for full delivery, and the Senior Supplier cannot authorize the project on behalf of the Board.
